ATLANTIC YARDS RATNERVILLE CONSTRUCTION UPDATE (ILLUSTRATED)
ATLANTIC YARDS CONSTRUCTION UPDATE
Weeks beginning February 25, 2008 – March 3, 2008
Long Island Rail Road/Vanderbilt Yard Work
- Excavation, lagging, install walers and struts at Support of Excavation (SOE) piles at Southeast Gas Station (block 1121, lot 47).
- Continue construction and debris removal from block 1121.
- Continue hauling soil from block 1121.
- Drill piles at East Portal.
- Trench and install conduit in block 1120.
- Prep and begin demo of southern portion of Carlton Avenue Bridge.
Install protection for traffic and pedestrians on Pacific Street near 6th Avenue in preparation for the installation of a footing for the south foundation of the cable bridge.

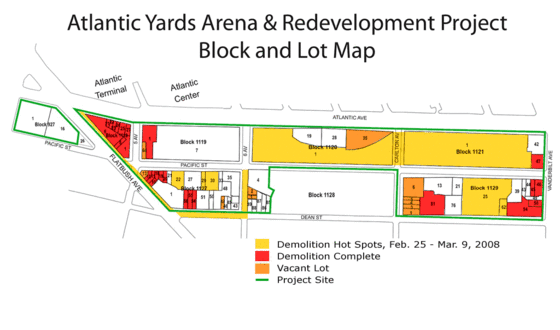

Abatement and Demolition Work
All work described below will comply with the additional oversight and protocols by the Department of Buildings (DOB) that were established on April 30th.
- Demolition is underway at 800 Pacific Street (block 1129, lot 25) and will continue throughout this two week period.

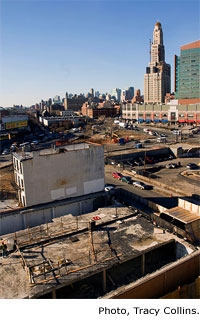

- Demolition is underway at 626 Pacific Street (block 1127, lot 22) and will continue throughout this two week period.
- Abatement is complete at 642-646 Pacific Street (block 1127, lot 30). Demolition will begin within this two week period.
- Abatement will begin at 640 Pacific Street (block 1127, lot 29) and will continue throughout this two week period.
- Abatement is complete at 645 Dean Street (block 1129, lot 62).
- Fencing, back fill and clean up is complete at 546 Vanderbilt Avenue (block 1129, lot 54). Parging of adjacent walls will be underway throughout this two week period.
Utility Work
All utility work scheduled to take place in Flatbush Avenue will only take place at night (between 10PM and 6AM) as mandated by DOT.
- The first of three phases of upgraded water and sewer installations is underway and is expected to continue through the end of the year. Work will continue on Dean Street between Flatbush and Sixth Avenues and on Sixth between Pacific and Dean Streets. Night time work began on Flatbush Avenue at Dean Street and will continue north along Flatbush in the next two weeks. Work will also begin on a new sewer chamber on Dean Street near Flatbush during the day.
- Transit ducts on Flatbush Avenue between Atlantic Avenue and Dean Street will be relocated. This work is expected to continue over the next three months.
Transportation Update
The B65 bus stop on Dean Street at the east side of Flatbush Avenue has been temporarily relocated further east on Dean Street between Carlton and 6th Avenues to accommodate utility work described above.
On January 23, 2008, the Carlton Avenue Bridge, located between Atlantic Avenue and Pacific Street, was closed. Northbound traffic is being rerouted either west along Pacific Street to Sixth Avenue, which has been restriped as a two way street, or east along Pacific Street to Vanderbilt Avenue.
