ATLANTIC YARDS RATNERVILLE CONSTRUCTION UPDATE

ATLANTIC YARDS CONSTRUCTION UPDATE
Weeks beginning January 14, 2008 and January 21, 2008

Long Island Rail Road/Vanderbilt Yard Work

  • Mid-block Support of Excavation (SOE) piles. Tie backs installed.
  • Continue drilling SOE piles at Southeast Gas Station (block 1121, lot 47).
  • Excavation, lagging, install walers and struts at SOE piles in Southeast Gas Station (block 1121/lot 47).
  • Continue drilling SOE piles adjacent to East Portal.
  • Continue preparing site for mobilization to East Portal to drill SOE and foundation piles.
  • Continue drilling Temporary Train Trestle foundation piles in block 1121.
  • Prepare placement of concrete in west abutment foundation of train trestle.
  • Continue construction and debris removal from block 1121.
  • Pour foundations for temporary access ramp to yard level in block 1120.
  • Trench and install conduit in block 1120 (for future cable installation from cable bridge in block 1120, parallel to 6th Avenue Bridge).

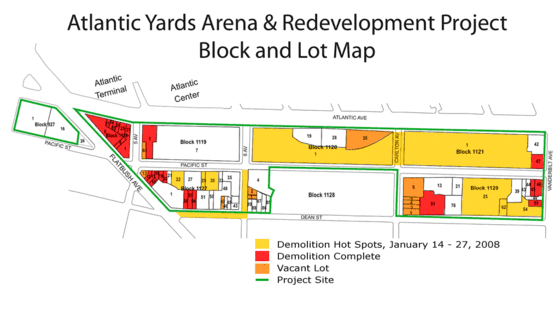

Abatement and Demolition Work

All work described below will comply with the additional oversight and protocols by the Department of Buildings (DOB) that were established on April 30th.

  • Abatement will be underway at 642-646 Pacific Street (block 1127, lot 30) within this two week period.
  • Abatement will be underway at 645 Dean Street (block 1129, lot 62) within this two week period.
  • Demolition is underway at 546 Vanderbilt Avenue (block 1129, lot 54) and will continue for the next one–two months.
  • Abatement is complete at 626 Pacific Street (block 1127, lot 22). Demolition will be underway within this two week period.

Utility Work

  • The first of three phases of upgraded water and sewer installations is underway and is expected to continue for four to six months. Work started on Dean Street at Flatbush Avenue, continued along Dean to 6th Avenue and will proceed along 6th from Dean to Pacific Streets. Work will also take place along portions of Pacific Street.
  • Transit ducts on Flatbush Avenue between Atlantic Avenue and Dean Street will be relocated. This work will only take place at night (between 10PM and 6AM), and is expected to continue over the next three months.

Transportation Update

  • The B65 bus stop on Dean Street at the east side of Flatbush Avenue has been temporarily relocated further east on Dean Street between Carlton and 6th Avenues to accommodate utility work described above.
  • Beginning approximately January 23, 2008, the Carlton Avenue Bridge, located between Atlantic Avenue and Pacific Street, will be closed.
